April 23, 2024 – Vancouver, B.C. – Solaris Resources Inc. (TSX: SLS; NYSE: SLSR) (“Solaris” or the “Company”) is pleased to report the first drill results from its 2024 drilling program and an exploration update at its Warintza Project (“Warintza” or “the Project”) in southeastern Ecuador. Highlights are listed below, with a corresponding image in Figures 1-2 and results in Tables 1-2.
Highlights
Drilling activities ramped up through the first quarter rainy season with six rigs now in operation at Warintza Central, East and Southeast and drilling expected to continue throughout the year in support of expanding and upgrading resources. In addition, follow-up exploration drilling is set to commence at the Patrimonio discovery and regional exploration is underway at the promising Caya epithermal gold target.
- SLS-76 was collared on the northeastern limit of the Northeast Extension zone and drilled northwest, returning 150m of 0.67% CuEq¹ within a broader interval of 384m of 0.51% CuEq¹, before the hole was terminated in lower grade mineralization
- SLSE-31 was collared on the southern margin of Warintza Southeast and drilled east to the ~300m depth capacity of the KD-200 rig, returning 284m of 0.53% CuEq¹ from near surface, with the final 10m averaging 0.75% CuEq¹ and remaining open for extension drilling with a larger rig
- SLS-75, drilled northeast from a new 200m step-out platform at Northeast Extension zone, returned 26m of 0.52% CuEq¹ and 46m of 0.66% CuEq¹ within a low-grade section from surface with a post-mineral dyke before a final 62m mineralized interval averaging 0.51% CuEq¹
- SLSE-32 was collared on the northern margin of Warintza East and drilled north, returning 380m of 0.31% CuEq¹ from surface within a broader interval of 634m of 0.27% CuEq¹ where the hole cut the contact of the primary host lithology with bordering lower grade volcanic rock
- Exploration drilling is underway at Patrimonio to follow up on the discovery holes (144m of 0.50% CuEq¹ and 148m of 0.52% CuEq¹, respectively – refer to press release dated September 12, 2023) while field crews expand sampling coverage over the highest grade part of the anomaly to the south and down-dip of the replacement mineralization to locate the potential porphyry source
- Regional exploration programs are underway at the promising Caya epithermal gold target, located 6km to the northeast of Warintza East, where field crews are expanding sampling and alteration mapping to the west to cover an area where evidence of historical artisanal mining has been identified
- Funded for 2024 and 2025 programs with the offtake financing package announced in December, with plans to aggressively expand activities and consolidate the surrounding district with funds from closing the strategic investment announced in January
2024 Drilling Program and Funding
The 2024 drilling program has progressively ramped up over the rainy season with approximately 700m drilled in January, 1800m in February, 3800m in March, and on track for 5,200m in April with six rigs now in operation. A minimum of 30km of drilling is planned in 2024, with a Mineral Resource Update expected by the end of June, and drilling planned to continue thereafter.
The Company is funded for its 2024 and 2025 programs with the offtake financing package announced in December. As at December 31, the Company had approximately US$39 million in cash and equivalents, with an additional US$40 million expected from its offtake financing package (refer to press release dated December 11, 2023).
The Company plans to aggressively expand activities and consolidate the surrounding district with funding from the closing of the strategic investment (refer to press release dated January 11, 2024). The parties are continuing to work through the Canadian regulatory process to close the transaction and Solaris will update the market when it has a material update to provide.
Regional Exploration: Caya Epithermal Gold Target
Field crews have recently been active at the Caya target (refer to Figure 2), where stream sediment sampling has identified a 5km x 3km gold anomaly, 6km northeast of Warintza East. Soil sampling has defined an open-ended area of 0.7km x 1.3km in which anomalous gold and other epithermal pathfinder elements are concentrated and obscured by an overlying stratigraphic unit.
The soil anomaly coincides with clay alteration in which dickite is enclosed by high-crystalinity koalinite that grades outward into clay minerals that were develped at successively lower temperature. Such hydrothermal alteration zoning, combined with sporadic occurrences of vuggy silica that have been found, are typical of high sulphidation epithermal systems.
The target is relatively flat-lying mineralization in permeable strata adjacent to feeder faults. Sampling conducted over the last month has extended the soil grid to the west to cover an area of historical disturbance from past artisanal mining. Given the flat-lying nature of the conceptual target, additional spectral work is being done to refine the alteration zoning in the volcanosedimentary layers that overlie the target. The Company expects to report on the results of this work in more detail in June.

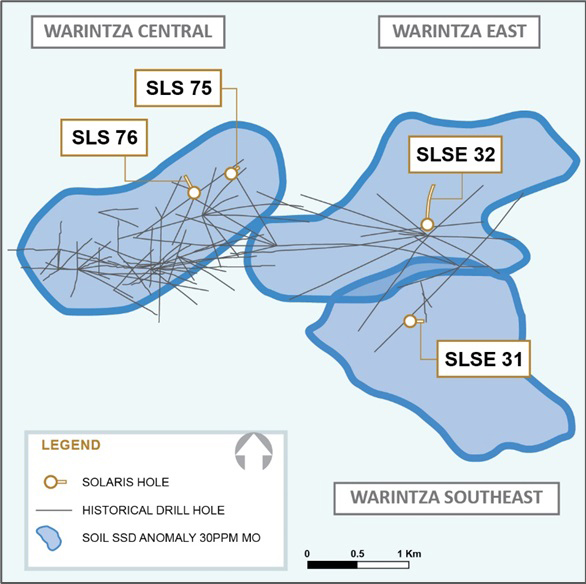

Figure 1 – Plan View of Drilling to Date

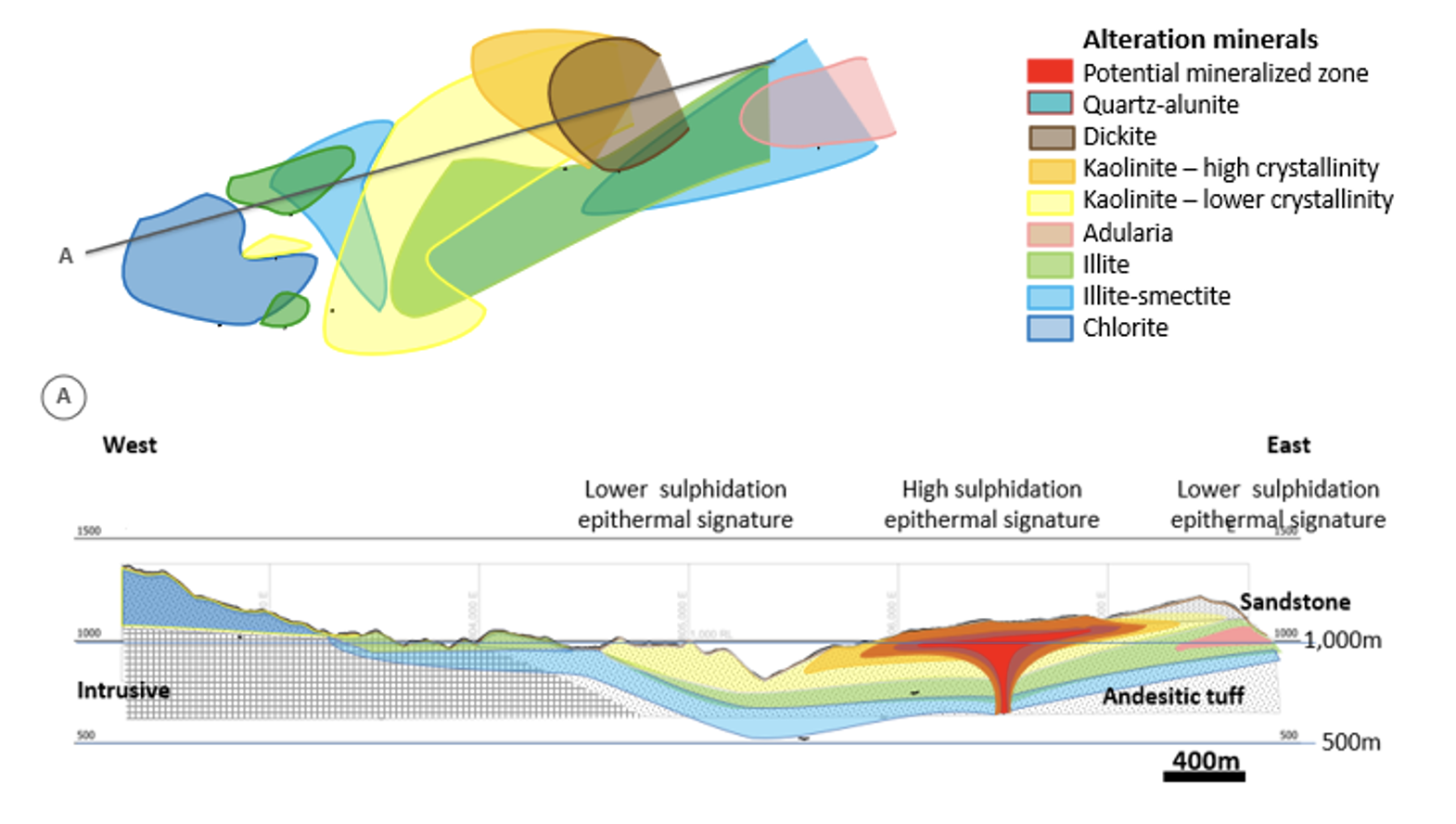

Figure 2 – Caya Epithermal Gold Target
Table 1 – Assay Results
Hole ID |
Date Reported |
From (m) |
To (m) |
Interval (m) |
Cu (%) |
Mo (%) |
Au (g/t) |
CuEq¹ (%) |
SLS-76 |
Apr 23, 2024 |
78 |
462 |
384 |
0.35 |
0.03 |
0.07 |
0.51 |
Including |
78 |
228 |
150 |
0.46 |
0.04 |
0.08 |
0.67 |
SLS-75 |
16 |
42 |
26 |
0.38 |
0.02 |
0.11 |
0.52 |
Including |
130 |
176 |
46 |
0.49 |
0.02 |
0.15 |
0.66 |
Including |
472 |
534 |
62 |
0.43 |
0.01 |
0.09 |
0.51 |
SLSE-32 |
4 |
638 |
634 |
0.21 |
0.01 |
0.02 |
0.27 |
Including |
4 |
384 |
380 |
0.25 |
0.01 |
0.03 |
0.31 |
SLSE-31 |
26 |
310 |
284 |
0.44 |
0.02 |
0.05 |
0.53 |
Including |
300 |
310 |
10 |
0.64 |
0.02 |
0.05 |
0.75 |
Notes to table: True widths are interpreted to be very close to drilled widths due to the bulk-porphyry style mineralized zones at Warintza.
Table 2 - Collar Locations
Hole ID |
Easting |
Northing |
Elevation
(m) |
Depth
(m) |
Azimuth (degrees) |
Dip (degrees) |
SLS-76 |
800350 |
9648417 |
1351 |
493 |
330 |
-80 |
SLS-75 |
800531 |
9648518 |
1261 |
534 |
60 |
-85 |
SLSE-32 |
801483 |
9648241 |
1170 |
860 |
0 |
-78 |
SLSE-31 |
801395 |
9647790 |
1184 |
310 |
90 |
-80 |
Notes to table: The coordinates are in WGS84 17S Datum.
Endnotes
- Copper-equivalence calculated as: CuEq (%) = Cu (%) + 4.0476 × Mo (%) + 0.487 × Au (g/t), utilizing metal prices of US$3.50/lb Cu, US$15.00/lb Mo, and US$1,500/oz Au, and assumes recoveries of 90% Cu, 85% Mo, and 70% Au based on preliminary metallurgical test work. For additional details on the intervals, refer to press release dated September 12, 2023 for SLSP-01: 144m of 0.50% CuEq (0.34% Cu, 0.03% Mo, 0.09 g/t Au) and SLSP-02: 148m of 0.52% CuEq (0.38% Cu, 0.02% Mo, 0.09 g/t Au).
